Residential Construction Estimating Services for Builders and Remodelers
Reliable residential construction estimating services for custom homes, spec builds, and remodels. Coded to your chart of accounts in NAHB cost codes or CSI master formats, our line-item estimates ship as fully editable spreadsheets matched to your framer and lumber yard pricing, delivered in 24 to 96 hours so you can lock in sub-quotes without paying for a full-time in-house estimator.
In every residential package
- Unlocked Excel or CSV in NAHB cost codes, CSI 01-49, or both
- An allowance schedule with a unit basis behind every dollar
- Marked-up sheets in color, keyed to the workbook row
- Written assumptions, inclusions and exclusions
- Estimator self-check, then a second-estimator audit
Where profit margins disappear without a residential construction cost estimator
Few builders lose money because the main framing number was wildly off. Profit drains in the small gaps between the initial estimating for residential construction and final occupancy, and accurate residential cost estimating means catching those blind spots before framing starts.
What our residential estimating services actually deliver
Residential cost estimating is only worth what the file is worth, and a residential building cost estimator earns the fee in the file rather than the sales call. Here is what lands in your inbox, and the decision that changes which package you should buy.
The four files
The same four parts on one custom home and on a twenty lot release.
The line-item estimate
Excel or CSVQuantity, unit, unit cost and extension on every line, labor and material split so you can overwrite one without disturbing the other. No locked cells, no rolled-up total hiding a number.
A rate column you are meant to overwrite
Baselines come from RSMeans and the National Construction Estimator, adjusted for the market. Drop your framer's number and your yard's quote into the rate column and the sheet recalculates. You buy quantities and structure, not a price you must take.
Coded to your books, not to ours
NAHB cost codes, CSI 01-49, or both columns on the same sheet. Send your chart of accounts with the plans and the workbook lands in your numbering.
The allowance schedule
Its own tabEvery unselected item with a unit basis, a quantity and a figure. Not a lump sum for flooring, but 2,000 SF at a stated installed rate per SF. Overage terms sit beside it, agreed at estimate time, the only time anybody agrees to them calmly.
The color-coded markups

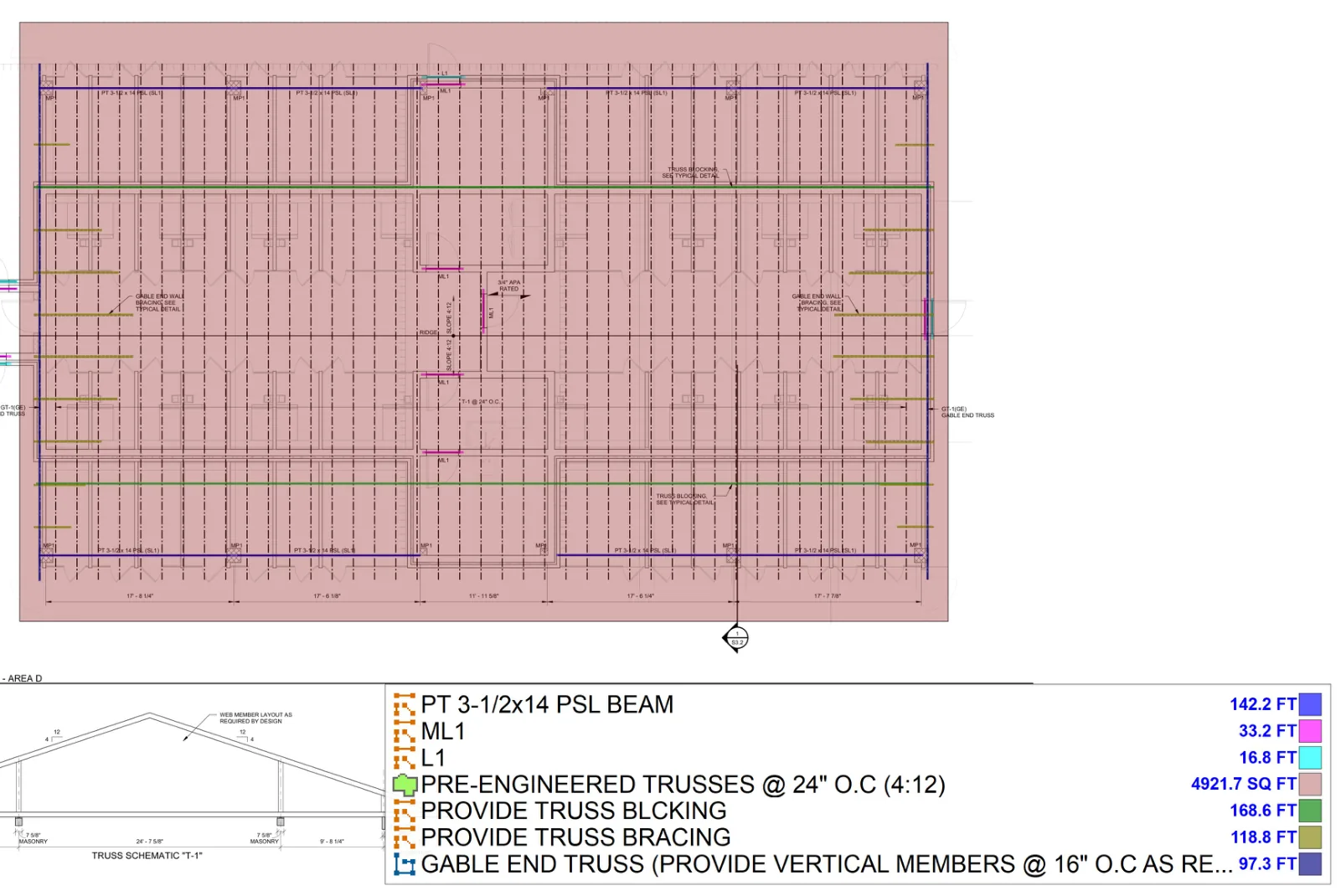

PDFEvery wall run, roof plane and fixture count marked on the sheet it was measured on and keyed to the workbook row. Wall types stay separated: 2x4 and 2x6 exterior, partition, wet wall and rated party wall never average into each other.
Assumptions, inclusions and exclusions
One pageWhat was counted, what was assumed, what was left out. On a fixed price house this is the page that decides who pays for the thing nobody drew.
Quantities only, or quantities priced
The decision no competitor draws for you, and the one that changes what you should pay.
Quantities only, when you buy the job out
MeasuredCollecting sub bids is a pricing method, not an absence of one. What you lack is the measurement that holds a framer to their number, catches the sub who bid off a superseded issue, and shows the scope nobody claimed.
Fully priced, when one number leaves the office
PricedWhen a figure goes to a buyer, a bank or your own call on a lot, you need the build-up: crews and production behind the labor rows, allowances with a basis, contingency and escalation on lines you can delete.
See a sample packageWin more profitable bids with zero overhead
Send us your first plan set today. A fixed price quote and a clear 24-96 hour turnaround come back within hours, with no upfront commitment required.
Estimating takeoff for upgrades and structural variances
Buyers buy options as single upgrade lines, but builders absorb the downstream structural changes. Professional residential cost estimating tracks both the buyer price and the hidden costs behind the wall, so you price the whole cascade instead of absorbing the adjustments nobody saw coming.
Accurate residential cost estimating mapped to your draw schedule
Lenders review draw milestones before releasing funds, and a front-loaded budget that puts too much cost into the early draws goes straight back across the desk. Our residential building cost estimator reports align each line item directly with standard bank draw milestones, so residential cost estimating flows through the loan the way the lender reads it.
| Draw 1 | Permits, site and foundation complete | 15-20% | Fees, clearing, cut and fill, footings, slab or stem |
|---|---|---|---|
| Draw 2 | Framing and dry-in complete | 20-25% | Lumber, trusses, hardware, sheathing, roof, windows |
| Draw 3 | MEP rough and insulation passed | 15-20% | Plumbing, HVAC and electrical rough, insulation |
| Draw 4 | Drywall, trim, cabinets, exterior | 20-25% | Board and tape, trim, cabinetry, siding, brick, paint |
| Draw 5 | Final trim, flooring and the CO | 15-20% | Flooring, fixtures, appliances, punch, final grade |
| Retainage | Held back until completion, not a sixth draw | 5-10% withheld | Taken from every draw, not parked on the last |
Industry-standard residential construction estimating services
Home builders run NAHB cost codes in job-costing software while lenders read CSI divisions, so our residential construction estimating services deliver both formats in parallel, built directly for your chart of accounts, and accounting, bank approvals and audit compliance all read the same file the same way.
The three formats every file ships in
One workbook, coded so the builder, the lender and your own history can all use it.
NAHB cost code formatting
For the builderSite work, shell, rough MEP and interior finishes organized the exact way homes are built and funded, tracked line by line in your chart of accounts rather than a textbook version, with import-ready CSV for Buildertrend, CoConstruct or QuickBooks instead of a locked PDF.
CSI division breakdown
For the reviewerFully aligned with CSI 01-49 divisions so lender evaluations and formal audit reviews stay fast and clear, sitting alongside the builder codes on the same sheet.
Historical job-cost alignment
For the next bidNational averages lead to inaccurate bids, so standardized coding across every project lets you compare final costs against the original estimate line by line, and your own closed work sharpens future bidding accuracy.
Cost plus or fixed price changes what the estimate has to do
The same house and the same quantities produce two different documents. What changes is who holds the risk on the day a number turns out wrong.
Cost plus and a guaranteed maximum
Under cost plus the estimate is a budget the client reads and a control document you build against. A miss surfaces as a conversation in month three, not as your money. Under a guaranteed maximum it becomes a ceiling and every assumption becomes contractual.
Fixed price and lump sum
Under fixed price the estimate is your risk position for nine months. Every quantity you missed is yours, every allowance you set low is yours the moment the buyer picks, and escalation before the framing order is yours unless the contract says so.
Unit price work inside a residential contract
Rock excavation by CY, extra pier depth by LF, fill by the load, well depth by the foot. Where nothing can be quantified until the machine is on the lot, a rate agreed in advance turns a fight into arithmetic.
Residential vs commercial construction estimating
Residential prices to NAHB codes, an allowance schedule, a draw schedule and a buyer who keeps changing selections. Commercial prices to CSI divisions, an owner's bid form, alternates and unit prices, and a bid opening at a stated minute.
Commercial construction estimating servicesPut the whole season on a monthly partnership
Starts bunch up in spring and go quiet in February. The monthly partnership runs a priority queue with unlimited revisions and revised plan issues included, and a quiet month carries into the next one instead of paying for an idle desk.
Home builder estimating services, per bid, monthly or dedicated
Three ways to run an outsourced estimator for home builders, and one honest case for none of them. Residential volume is never flat, and a salaried seat costs the same in February whether you started a house or not.
| Best for | One custom home, or a first job with us | Two or more houses started a month | A plan library and a release calendar |
|---|---|---|---|
| Against in house | ~25-35% less | ~40-55% less | ~35-45% less than a loaded seat |
| Commitment | None, one house at a time | Flat monthly retainer | One estimator assigned to your work |
| Delivery | 24-96h from an approved quote | 24-96h priority queue | 8 hours a day, 5 days a week |
| Revisions | Included on unchanged scope | Unlimited, revised plan issues included | Included on unchanged scope |
| Quality check | Two-step QA | Two-step QA | Two-step QA, same estimator each time |
| Your cost codes | On request | Standing | Standing |
| A slow February | You spend nothing at all | Queue carries into the next month | The estimator works your backlog |
| Do not buy it when | You already priced this exact plan | You start fewer than four houses a year | Your work will not fill a 40 hour week |
What builders ask before they send the plans
The questions that come in the week a builder decides whether to hand the plan set over.
What you get
Accuracy and timing
Money
Fit
Price your next house
before you price the lot
Upload the plan set, name the elevation, and say whether a buyer, a bank or a lot decision reads the number. A fixed price and a delivery date come back in writing.
